In August 1978, Turkey owed Iraq roughly $300 million for oil. Its energy minister named wheat, peas, household appliances and buses among the exports whose proceeds would help clear the bill.1
Turkey needed Iraqi oil. Iraq needed the Turkish pipeline to carry crude to the Mediterranean. The customer who had fallen behind on payment also controlled an outlet for the supplier.
Deliveries to Turkey had been interrupted. An agreement signed on 25 August promised to restore them. Three days later, the American embassy in Ankara reported that Iraq must have extracted a price for the concession.
“We don’t know yet what it is.”1

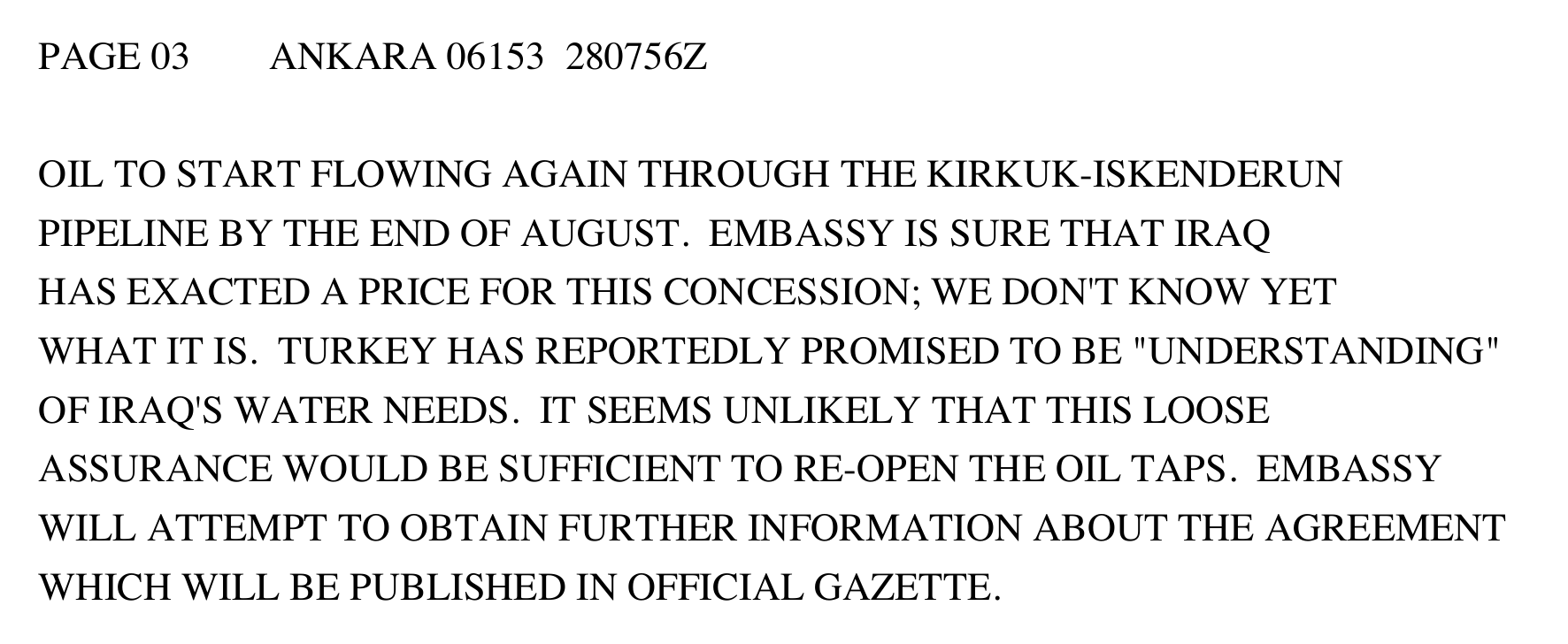

Ankara 6153, 28 August 1978, paragraph 5 (continued). A direct excerpt from the released-text PDF, not an original telegram scan. Released PDF
On 31 August, a Turkish foreign-ministry petroleum official, Ferhat Ataman, supplied a fuller account. Current oil purchases would be paid for within sixty days. Export proceeds would discharge the old debt through an arrangement between the central banks. He was not at liberty to disclose the timetable.1
Ataman also described an oral assurance about the planned Karakaya dam. Turkey would not use it in a way that harmed Iraq. Baghdad would resume its position as Turkey’s leading oil supplier through 1979. The embassy suspected he was understating the water commitment. When the oil arrangement came up for extension, its diplomats reasoned, Iraq might seek an assurance about the next dam, then the next.1
Turkey had an oral assurance of its own. Iraq would pay royalties “as though the pipeline were operating at full capacity”. The 1973 treaty already provided for minimum annual payments. Here was a further promise, reported inside a settlement over oil, debts and water.1
These were American diplomats relaying Turkish accounts. The cables disagree over the part played by technical trouble and political pressure in interrupting supplies. They do not establish that transit to third countries stopped altogether. The written August agreement has not been located.1
Even with those limits, the bargain shows how much could be required to resume deliveries through an existing pipe. Nearly half a century later, Turkey would declare its section technically ready. Exports would take almost two more years to return.2
What had to be restored after the pipe was declared ready?

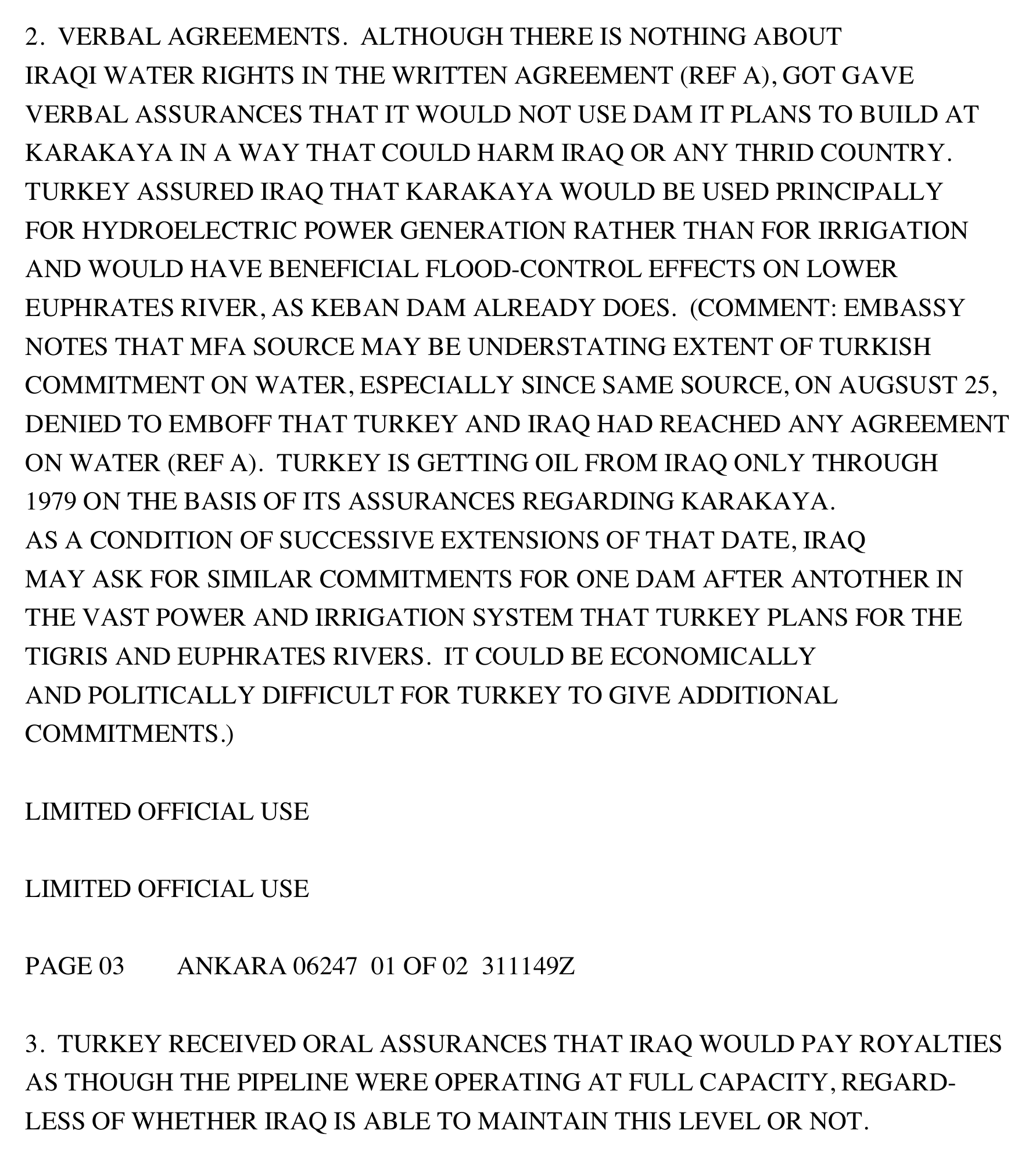

Ankara 6247, 31 August 1978, paragraphs 2–3: the oral assurances on water and royalties. Direct excerpt from the released-text PDF. Released PDF
· · ·
Iraq had built itself some room to negotiate. Its strategic pipeline carried northern crude south to the Gulf without crossing a foreign border. In January 1976, the American mission reported the first tanker shipment and expected Baghdad to press Syria over transit fees. Later that year, the CIA credited this line and the new Turkish route together with giving Iraq greater freedom to negotiate.3
By November 1978, a BOTAŞ official said the Turkish line had been pumping 540,000–625,000 barrels a day since the late-August resumption, apart from a fire interruption in October. He claimed repairs had taken nine days. Other contemporary accounts put the return later.4
Northern crude was also travelling south through the strategic line. Yet the embassy still saw a reason for Baghdad to reopen Syria: a third outlet could reduce Turkish leverage over water, transit fees and Kurdish relations.4
Within four years, those choices had narrowed. War had shut the Gulf outlets; Syria closed its pipeline in 1982. Turkey was left as Iraq’s only export outlet, in the CIA’s assessment, with capacity of about 700,000 barrels a day. Before the war, Iraq had exported more than three million.5
The Turkish line could not replace that lost volume. It did carry oil Iraq could sell to help pay for the war. Sabotage had interrupted it only briefly, the CIA reported.5
There was a reciprocal undertaking behind that service. Turkey had promised to maintain the flow and load oil as Iraq required. Iraq had promised minimum annual payments, except in cases of force majeure. In 1985, the guaranteed volume rose to 35 million tonnes. A second line expanded the route in 1987.5
Iraq also financed a route across Saudi Arabia to the Red Sea. The CIA warned that it depended on Saudi willingness, while expecting Riyadh to accommodate Baghdad. Oil began flowing in 1985. By Iraq’s later count, the line carried 876 million barrels before closing in 1990.6
Then Iraq invaded Kuwait. Turkey closed its line under the UN embargo in August 1990. The Saudi route closed that month too, although the governments’ later accounts differed. Riyadh said it had “disconnected and blocked both ends” immediately after the invasion. Baghdad dated the halt to 13 August and said the reason given was high inventories at the terminal.6,7
In June 2001, Saudi Arabia declared that the pipeline and its associated facilities would revert to the Kingdom. Iraq called it “unlawful confiscation”. The investment remained across the border. Baghdad could no longer use it to export oil.6
· · ·
At Haditha, the K-3 junction connected the strategic pipeline with the northern lines. Southern crude could travel inland and turn towards either Mediterranean outlet. Damage at that junction could put both choices in doubt.

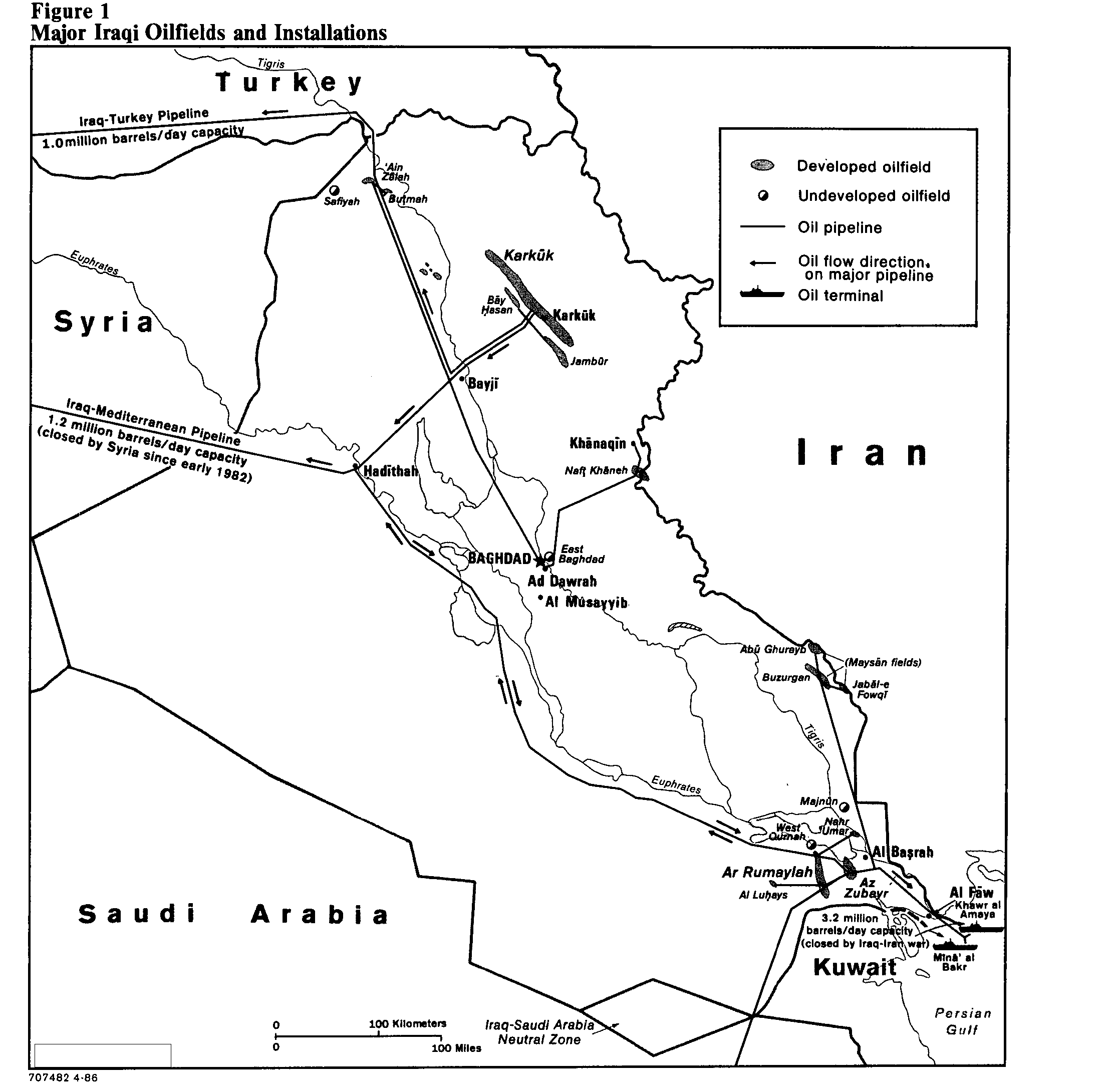

Iraq’s export routes in May 1986. The CIA map marks the Syrian line and Gulf terminals closed. Original map crop; full credit below.
K-3 and southern pumping stations were damaged in 1991; the EIA later reported repairs completed in 1992. In April 2003, American imagery showed installations burning near K-3 again. The accompanying assessment warned that destruction of the junction would prevent southern crude reaching either Turkey or Syria. It described a possible consequence, rather than establishing the full extent of the damage.7,8
In 2026, the exposure was spread across a region. War curtailed northern Iraqi output and Ceyhan exports, damaged Saudi Arabia’s bypass and disrupted Fujairah’s terminal. Several alternatives were affected by the emergency that had made them necessary.9
Saudi Arabia’s restart was reported in stages. Kpler’s imagery showed no tankers at Yanbu Crude or Muajjiz on 13 September. By the 27th, all seven Yanbu berths were occupied. Between those dates, the EIA reported repairs and a partial resumption of East–West pipeline flows. The occupied berths did not establish that normal volumes had returned.10
The public account names Saudi repair crews and authorities. It identifies no foreign government whose permission was required to restart. The passage beyond the pipe remained exposed: ships faced a Houthi threat in the Red Sea, Britain announced refuelling support, and France described personnel and equipment deployed to help protect Yanbu.10
For Iraq, a larger diversion of southern crude first requires work inside its own borders. In March, the IEA described limited connections to the north and a strategic pipeline needing repair. The proposed Basra–Haditha connection would open larger onward options towards Turkey, Syria or Jordan. Existing northern exports and road tankers can move without it. The larger southern diversion depends on it.11
A choice of ports begins with whether the oil can reach the junction.
· · ·
The Turkish line was idle in 1991. Its payment obligations were still alive.
When BOTAŞ brought its claim to the UN Compensation Commission, the panel found that minimum annual remuneration remained contractually owed for 1991–96. The Commission’s rules admitted only the 1991 loss, when war damage supplied a qualifying cause alongside the embargo. Excluding the later years from compensation did not cancel the underlying debt.12
The calculation reached down to the electricity the stopped pumps had saved. From a starting figure of $195.3 million, the panel deducted $18.96 million in avoided electricity costs. The approved award was $176.34 million.12
In 2016, a Turkish audit official told parliament that BOTAŞ had received approximately that principal. Interest was never paid. Oil had returned to Ceyhan much earlier: the first Oil-for-Food tanker loaded in December 1996. The programme paid Turkey’s pipeline charges from Iraqi oil proceeds.12
The minimum was not absolute. In its 2023 award, the tribunal excused Iraq’s minimum-throughput obligations from March 2003 through July 2007 under force majeure. Turkey still received an award of $46.25 million in ordinary charges for the oil actually carried.8
For 2014–18, the tribunal counted KRG barrels towards Iraq’s minimum even though they had left Ceyhan against the federal ministry’s instructions. Much of Iraq’s gross award concerned excess transport charges: the treaty tariff still applied to oil Baghdad had opposed loading. After Turkish counterclaims, the award left roughly $1.47 billion in Iraq’s favour before interest. It does not establish that Iraq collected the money.13
Minimum commitments also feature in Aramco’s and ADNOC’s pipeline financing, while operation remains under domestic control. They can support financing without giving another state control of transit.14
Iraq’s experience asks more of the contract. The minimum could preserve a claim to income for the operator during a closure. What would preserve Baghdad’s ability to earn from its oil?
· · ·
In August 2026, Ankara and Baghdad announced a one-year replacement for the treaty that had ended in July. Both used the figure of 750,000 barrels a day. Turkey called it allocated capacity. SOMO called it a minimum export quantity. Neither public description establishes what Iraq must pay if fewer barrels arrive.15
The following month, BOTAŞ recorded transport averaging about 262,000 barrels a day. Its ledger does not separate Iraqi from any Turkish crude in the total. Even taken together, the recorded traffic was far below the announced figure. For Baghdad’s accounts, the difference between reserving space and guaranteeing payment for it matters.15
Water is again part of the negotiation. Under the 2024 framework, Turkish purchases of Iraqi oil would finance water infrastructure in Iraq. A financing mechanism was signed in November 2025. Iraq’s Cabinet later authorised a first-stage ceiling of 33,000 barrels a day. That is a ceiling on the arrangement, not evidence of sales or money reaching an account.16
The published 2014 memorandum promises equitable and reasonable water releases after an assessment of resources and use. It fixes no volume. The recovered record supplies no clause exchanging specified oil volumes or prices for specified releases of water. In 1978, the assurance was oral. The present financing mechanism has been signed, but its text has not been recovered.16
The other routes remain at different stages. Fuel oil is reaching Baniyas by road through Syria. The Syrian and Jordanian pipeline plans remain proposals, and Jordan’s announced minimum pumping volume does not establish a bill for unshipped barrels.17,18 At sea, Baghdad announced an Iranian exemption for Iraqi oil passing through Hormuz; the IEA later described American escorts. Baghdad’s precise obligations behind that protection are not established in the reviewed record.19
To see what can delay a restart, the Turkish line offers a more complete account.
· · ·
After exports stopped on 25 March 2023, Gulf Keystone shut production at Shaikan completely in April. It recorded no revenue in the second quarter. Its annual report described a reduction of more than 60 per cent in the expatriate workforce. Roughly half the local workforce went onto reduced hours before local sales began.20
On 19 July, local buyers gave the field an outlet again. They paid in advance. In 2024, those sales generated $151.2 million.20
Turkey declared its section technically ready from 4 October 2023. The producers’ association, APIKUR, had already responded: its members needed clarity about payment for past deliveries and future sales, “even if the ITP reopens”.2,21
In August 2024, Gulf Keystone put the difficulty into its accounts. It warned that “reopening of the pipeline with a deferral of revenue receipts could result in liquidity pressures”. Local sales brought money before delivery. Returning to exports could mean waiting to be paid again.21
Iraq’s February 2025 budget amendment provided provisional advances of $16 a barrel for production and transport costs, subject to later reconciliation. In August, the Kurdistan government announced an export mechanism agreed with Baghdad. Federal coordination with Turkey still remained, it said. Turkey’s declaration of technical readiness had not completed that process.2,21
There were other impediments. Attacks damaged producing facilities in July 2025. The documents do not assign every month of the closure to one dispute. They do show that exports resumed while historic receivables remained under discussion.21
On 25 September, HKN announced an agreement in principle. The Kurdistan government and companies would meet within thirty days after exports resumed to work towards a mechanism for settling old debts. That meeting would follow the return of the oil.21
Later that day, ShaMaran reported executed interim agreements. Initial production and transport compensation would be $16 a barrel, adjusted after an independent consultant’s review. A nominated trader would pay the companies from cargo allocations at Ceyhan. Historic receivables were still being discussed.21
DNO took a different course. It would deliver the Kurdistan government’s share for export while selling the contractors’ share to local cash-and-carry buyers. Those buyers, it understood, had arranged to put the oil into the pipeline themselves.21
“We have elected not to engage directly in exports at this time,” its executive chairman, Bijan Mossavar-Rahmani, said.21
Exports resumed on 27 September 2025, thirty months after they stopped. By 10 December, Gulf Keystone had reported its first receipt under the new arrangements.2,21
Oil returned while historic receivables remained unresolved. The companies had described new arrangements for payment, almost two years after Turkey declared its section ready.
Before Baghdad guarantees income to a transit operator, what has it secured about the return of its own?
